Demolition Contractor Lead Gen System

The Demolition Contractors Lead Gen System is an automated workflow that finds buildings weeks before they come down, identifies the developer, owner, or general contractor who awards the demolition, and books site walks through personalized cold email.

Buying signals it watches

Designed by 2V Automation, an n8n Certified Expert Partner.

Flat ledger-style illustration of a commercial demolition site: an excavator with a shear opening a two-story building, sorted concrete and steel, and a roll-off container
~$179tools per month
350–600prospects per month
3–6%reply rate on triggers
6–15site walks per month

Best for / Not for

Best for

  • Demolition contractors doing $1M to $25M a year with excavators, a disposal account, and their own crews
  • Firms taking commercial, industrial, and interior strip-out work from 2,000 to 200,000 square feet
  • An estimator who can walk 6 to 15 sites a month and price each within three business days
  • Any US metro where permits, planning decisions, and code enforcement orders are published online

Not for

  • Residential teardown specialists, because homeowners are private individuals this system does not contact
  • Implosion and heavy industrial dismantling firms, whose work is won through a handful of national owner relationships
  • Contractors without pollution liability cover and a current safety record, since every general contractor asks for both first

How it works

1. Source

Five feeds, each on its own schedule, write into a single sites table.

FeedWhat it givesPulled
State and local asbestos notification logsAddress, owner, abatement contractor, building size, and planned datesDaily where published, monthly by records request elsewhere
Planning and zoning portalsApproved site plans and rezonings on parcels with existing structuresDaily
Code enforcement recordsUnsafe structure, condemnation, and demolition orders on commercial parcelsWeekly
Fire incident and news feedsCommercial structure fires with the address and the extent of damageDaily
Public bid portalsCity, county, and land bank demolition solicitationsDaily, sent to Slack only

Each row holds the address, the parcel’s owner of record, the building type and square footage from the assessor, the trigger type, the trigger date, and the fact the first email will cite.

2. Qualify

Nothing is enriched until the row clears these checks.

A parcel that fails only on stage is still recorded, because a permit issued to another contractor names the general contractor for the next job.

3. Enrich

Who awards the demolition depends on who controls the site.

Site controlled byThe seat
A developer with an approved projectThe development manager, then the project manager
A general contractor already namedThe preconstruction manager, then the chief estimator
An owner-occupier or a REITThe facilities or real estate director
A property held in an LLC with no staffThe managing member named in the state filing
A hospital, university, or school districtThe capital projects or facilities planning director

Hunter looks up the address from the name and domain, BetterContact confirms it, and the system tries one rung further down the list when the first seat fails.

4. Outreach

Five touches over 18 days: four emails and one call, each built from a fixed template per trigger type.

The language model writes only the opening two sentences, using the trigger record and the contractor’s own fleet and project history.

Three things the model is barred from:

  1. Asserting what is in the building. No statement about asbestos, lead, or any hazard the record does not state.
  2. Calling a building unsafe. A code order is cited by its date and type only.
  3. Pricing anything. Numbers come from the estimate workflow after a site walk.

Every email asks for the same thing: a 30-minute site walk and a budget number within three days.

5. Book and track

A webhook receives each reply, and a classifier sorts it into eight routes.

Public bids never enter the email sequence. They go to the estimator as a daily Slack list with the due date and the pre-bid meeting.

Lead sources for demolition contractors

1. Asbestos abatement notifications for whole buildings

This is the source competitors overlook, and it exists because federal asbestos rules require notice to the regulator before a regulated demolition or a large renovation starts.

Under the asbestos NESHAP, the owner or operator files a notification with the state or local agency at least 10 working days ahead. Many agencies publish these logs or release them on request.

The notices worth a row:

  1. Scope. Whole-building removal, or removal across most floors of the structure.
  2. Building. Commercial, industrial, or institutional, over 2,000 square feet.
  3. Demolition contractor. Blank, or the same firm as the abatement contractor with no demolition licence.
  4. Timing. Abatement start date inside the next 90 days.

A building being fully abated is almost always a building about to be demolished or gutted, and the abatement start date sets the clock.

Highest intent of the five, because the owner has already paid to prepare the structure for removal.

Expect 50 to 90 qualifying notices a month in a metro of 1 to 3 million people, an estimate that depends heavily on the state’s publication habits.

2. Approved redevelopments on occupied land

A site plan or rezoning approval on a parcel that still has a building on it is a demolition job with an owner, an architect, and a budget already attached.

The planning portal gives the applicant, the project description, the parcel, and the approval date. The assessor record adds the existing structure’s age, use, and square footage.

Why this row is valuable:

Expect 40 to 80 rows a month.

3. Unsafe structure and condemnation orders

Code enforcement publishes orders requiring an owner to repair or remove a dangerous building, and many cities put these lists online.

Order typeWhat it usually means
Unsafe structure noticeRepair or demolish within a set period, often 30 to 90 days
Condemnation orderOccupancy prohibited until the structure is repaired or removed
Demolition orderThe city will demolish at the owner’s cost if the owner does not

Only commercial parcels and parcels owned by companies qualify. Houses owned by individuals are excluded at the filter.

High intent with a deadline. Expect 30 to 60 rows a month.

4. Commercial fire damage

A commercial fire leaves an owner, an insurer, and usually a structure that has to come down in part or in whole.

Fire department incident data and local news give the address and a description of the damage. The assessor gives the owner of record.

The first message goes to the owner, never to a tenant, and it offers a site walk for the insurance scope. Timing matters: the owner hears from restoration firms within days, and demolition is usually decided within the first month.

Expect 20 to 40 rows a month.

5. Public demolition bids

Cities, counties, and land banks let blight demolition in batches, and those solicitations are public.

These rows skip outreach entirely. Procurement rules usually bar contact with the buying agency while a solicitation is open, so the system lists each bid for the estimator with the due date, the pre-bid meeting, and the bonding requirement.

Expect 10 to 30 solicitations a month, often covering several structures each.

The remaining prospect volume, 210 to 330 rows a month, comes from permit and planning records that name a general contractor for a project with existing structures on site.

ICP definition

Filter logic the workflow applies.

What starts a row

FilterRule
Abatement noticeWhole-building or most-floors removal, commercial or institutional use, abatement start inside 90 days
Redevelopment approvalSite plan or rezoning approved inside 60 days on a parcel with a structure over 2,000 square feet
Code orderUnsafe structure, condemnation, or demolition order inside 45 days on a parcel owned by a company or public body
Fire damageCommercial structure fire inside 30 days with reported structural damage
Named general contractorA building permit or bid award inside 60 days naming a general contractor, on a parcel with an existing structure
Public bidA demolition solicitation from a public body inside the radius, due in 7 days or more

What keeps a row

FilterRule
RadiusInside the yard’s working radius, default 60 miles
Owner typeOwner of record is a company, trust, or public body; individual owners are dropped
Size2,000 square feet or more of structure, or any industrial use
StageNo demolition permit issued for the parcel
ExclusionsOwner and general contractor absent from the customer, open-bid, and suppression tables on a 270-day window
Duplicate guardOne live row per parcel on a 180-day window
Volume cap15 rows per general contractor per quarter, so a busy builder hears from the contractor about its best-fit jobs only

Outreach sequence

The five steps

StepDayChannelGoal
10EmailOpener citing the abatement notice, the approval, the order, or the fire; offer a 30-minute site walk
23EmailSend the capability sheet: fleet, recycling rate, disposal partners, insurance limits, and safety rate
37PhoneCall the development or preconstruction desk with a one-line reason and the offer of a budget number
412EmailSend a price-per-square-foot range for that building type, clearly labeled as a budget before any walk
518EmailBreakup offering a free pre-purchase or pre-design walk for any future site

Example step 1 (abatement notice trigger)

Subject: [Address] after abatement

Hi [First name], the asbestos notification for [address] shows removal starting on [date] across [square footage] of [building type]. Once abatement clears, the structure itself still has to come down and leave the site.

We run [N] excavators out of [yard city], [N] miles away, and recycled [N]% of material by weight on last year’s commercial jobs.

Worth a 30-minute walk so you have a demolition number before abatement finishes?

Expected reply rate

Row typeExpected reply rate
Abatement notice rows4 to 7%
Redevelopment approval rows3 to 6%
Code order rows3 to 5%
Fire damage rows3 to 6%
Named general contractor rows2 to 4%

The 3 to 6% headline is an estimate for a warmed domain writing to development managers, facilities directors, and preconstruction staff.

Timing decides more than copy here.

An abatement notice written to in the week it is filed replies well. The same owner written to after the demolition permit is issued replies at roughly half that, because by then the demolition contract has been let.

Stack and running costs

ToolPurposeMonthly
n8n CloudOrchestration$24
Asbestos notification logsWhole-building abatement notices$0
Planning, permit, code enforcement, and assessor open dataApprovals, orders, permits, owner of record$0
ApifyFire incidents, news, bid portals, people search$39
HunterDecision-maker email finding$34
BetterContactWaterfall enrichment + verification$15
InstantlySending + warmup$37
Claude APIOpening lines, fire item extraction, reply classification$9
SourceToDocs (Starter)Branded budget estimate generation$19
Sending domainDeliverability$1
Supabase (free tier)Sites, yard profile, rate card, snapshots, suppression$0
Total~$179

SourceToDocs is built by 2V Automation, the team behind this library.

Why the records cost nothing

Every signal in this system comes from a public body that is required to keep the record, so the data line is free.

Construction project data services cover some of the same projects from roughly $300 to $1,500 a month, usually after the demolition contractor has been chosen.

What the workflows look like

Screenshots come from the imported workflows on our n8n showcase instance. The full node lists ship in the free spec PDF.

WF1 Sourcing workflow on the n8n canvas
WF1 · Sourcing. As imported on our n8n instance.

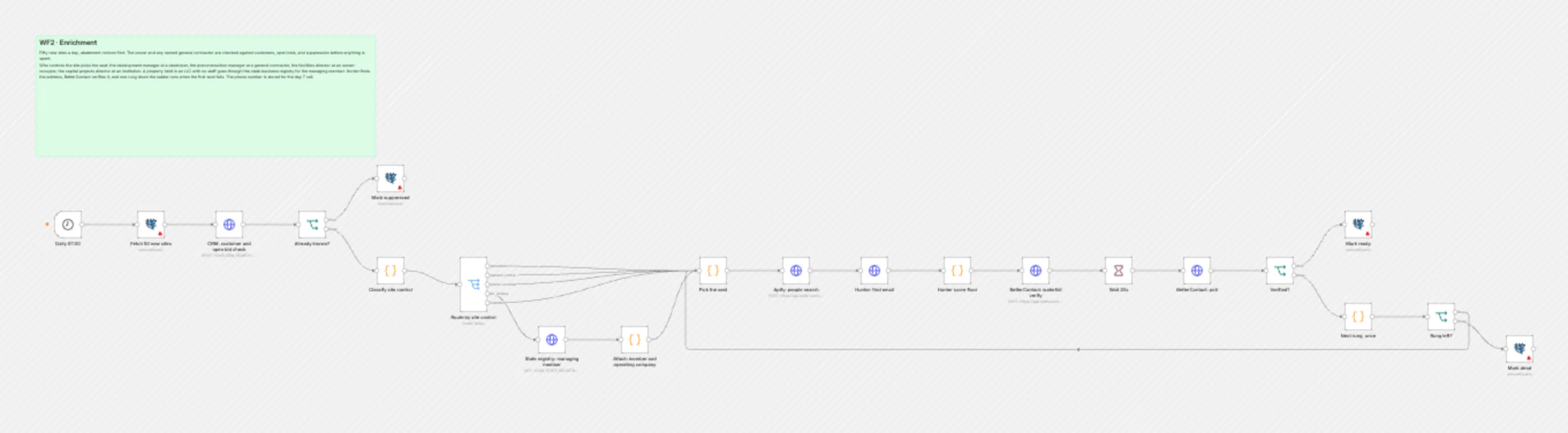

WF2 Enrichment workflow on the n8n canvas
WF2 · Enrichment. As imported on our n8n instance.

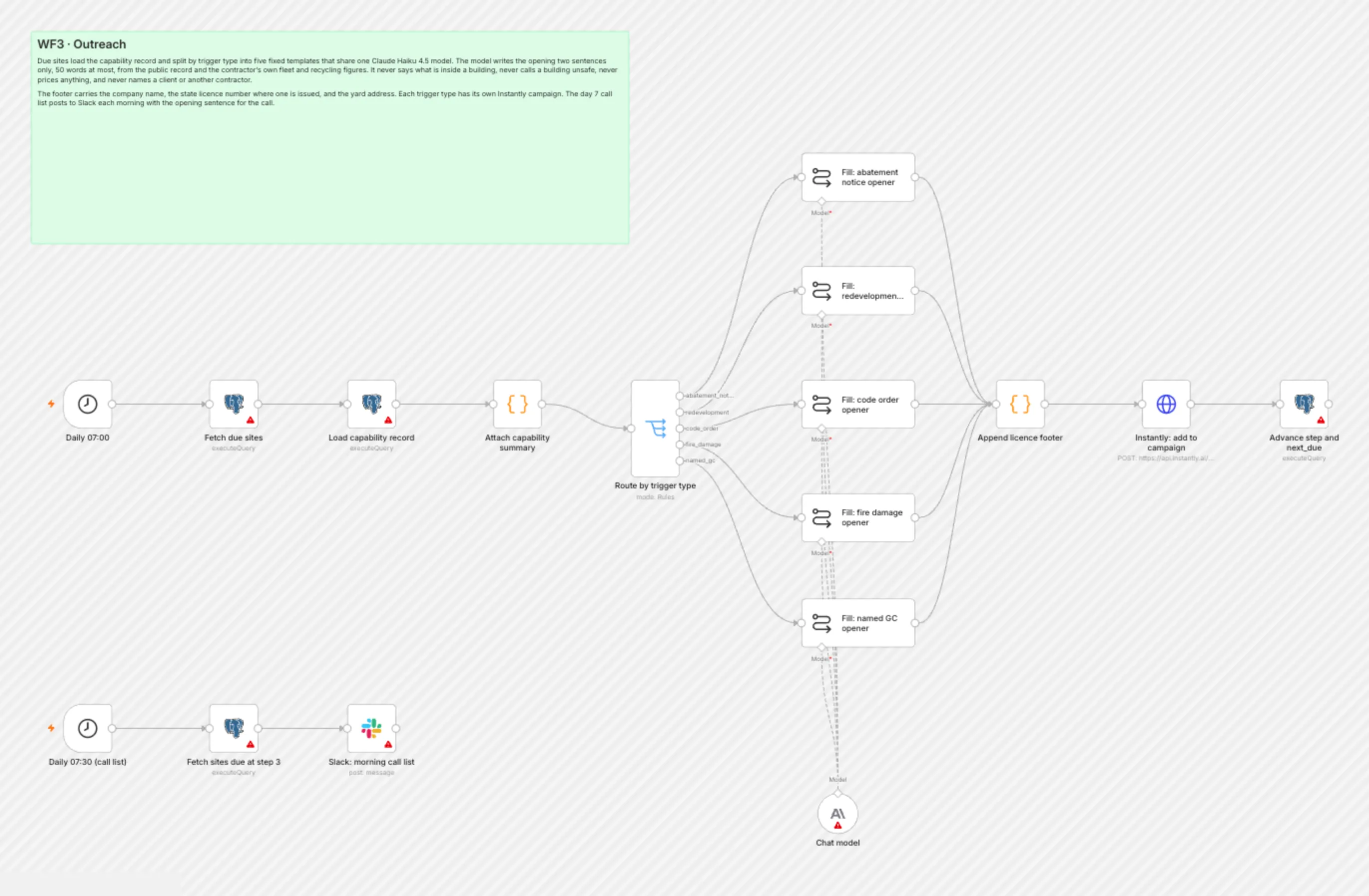

WF3 Outreach workflow on the n8n canvas
WF3 · Outreach. As imported on our n8n instance.

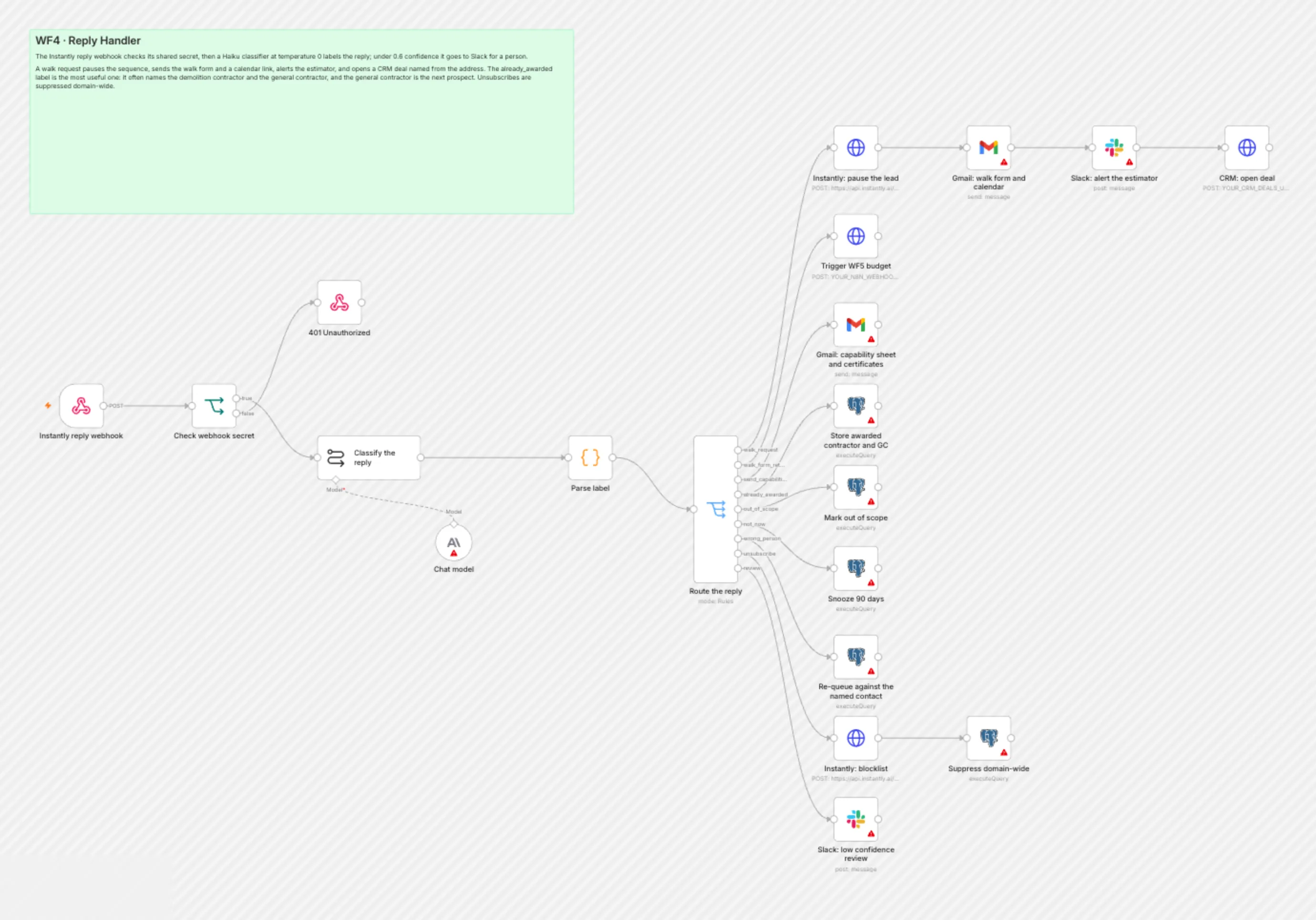

WF4 Reply Handler workflow on the n8n canvas
WF4 · Reply Handler. As imported on our n8n instance.

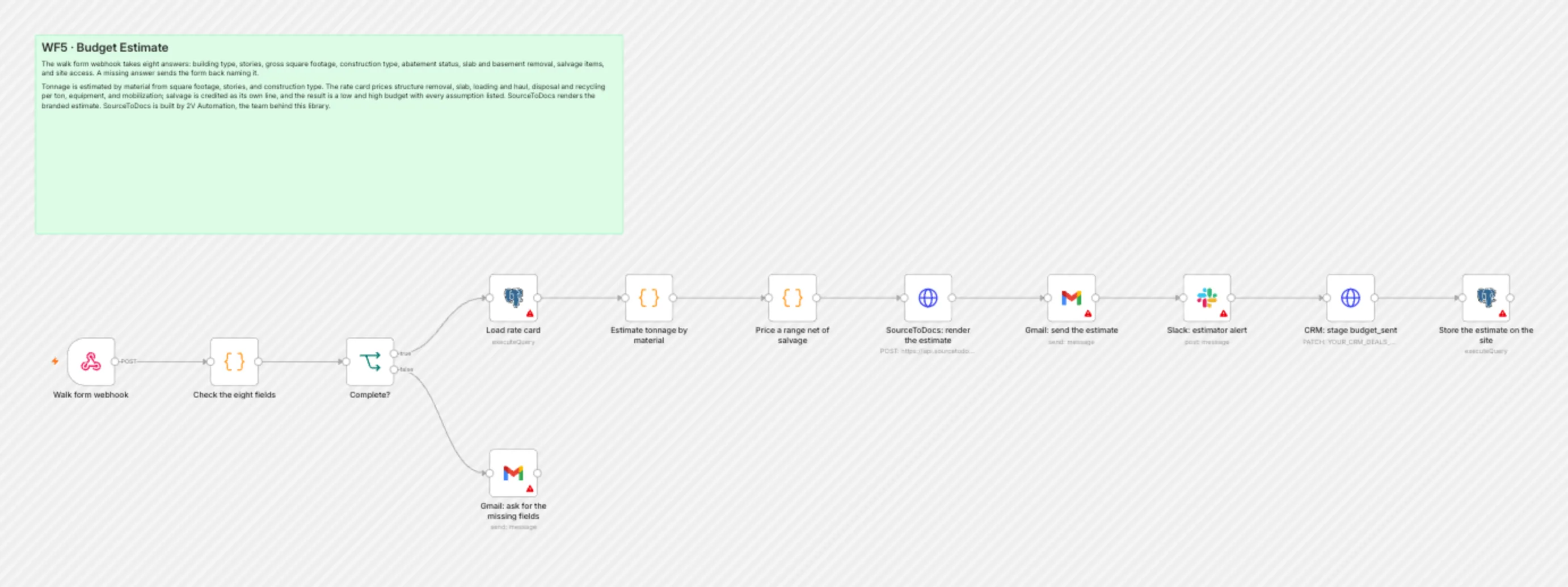

WF5 Budget Estimate workflow on the n8n canvas
WF5 · Budget Estimate. As imported on our n8n instance.

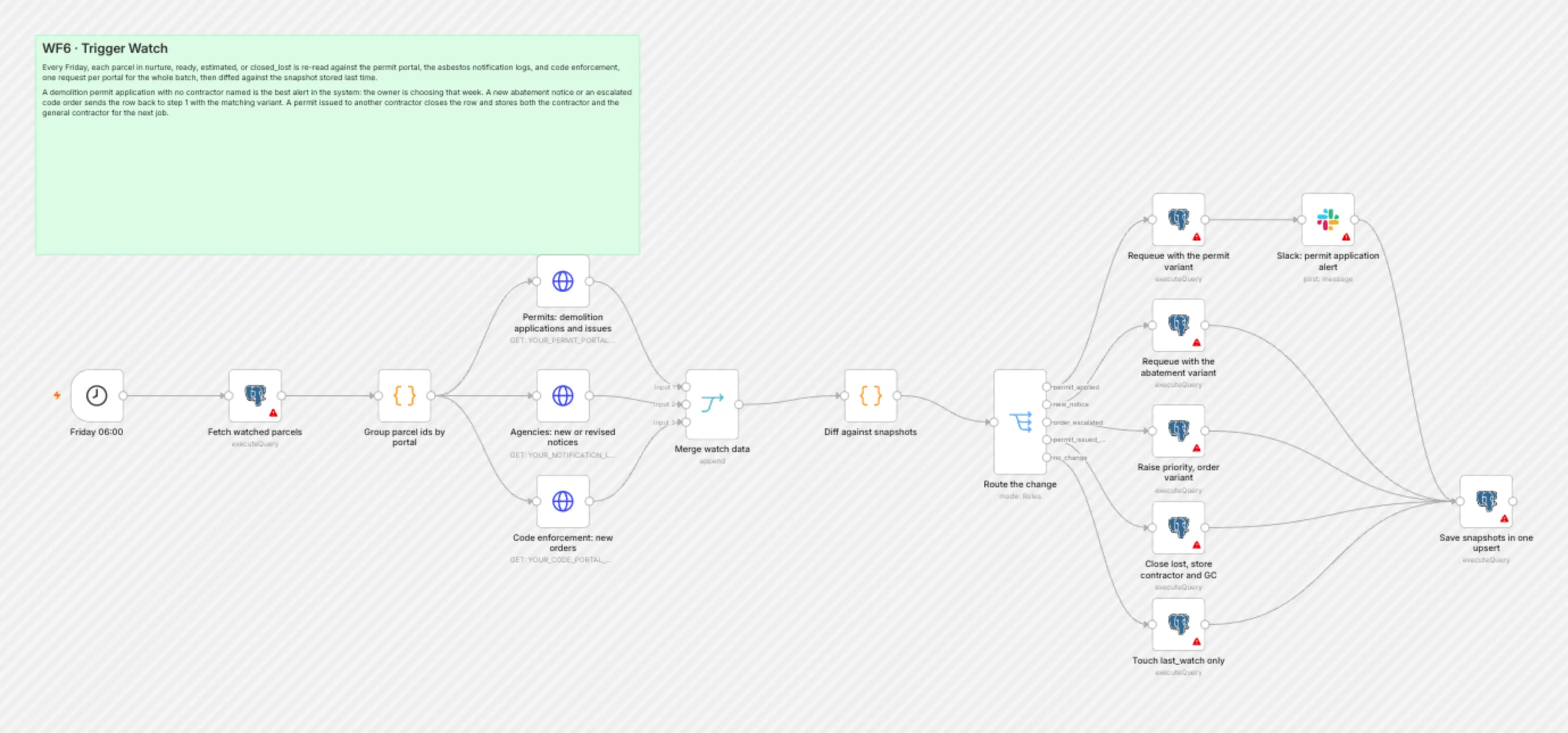

WF6 Trigger Watch workflow on the n8n canvas
WF6 · Trigger Watch. As imported on our n8n instance.

Get this system

Free

Full spec PDF

  • Complete workflow architecture
  • Every node config
  • Setup + deliverability checklists
  • Full email swipe file
Email me the spec
$297

The n8n template

  • Every workflow from the spec as importable n8n files
  • Instant automated delivery to your inbox
  • You add your keys, sources, and CRM. Sold as-is
Buy the template
$2,997

Installed for you

  • Custom sourcing for your exact territory: your city, your state, your country
  • Configured to your CRM, territory, and ICP
  • One setup call. Working within 5 business days
Book installation

Need more than this? Custom automation by 2V Automation. Book a call.

Get the full spec PDF by email

The PDF arrives in your inbox in about 2 minutes.

Frequently asked questions

How do demolition contractors get contracts?

Most demolition work is awarded weeks before the permit, when the developer or general contractor is still pricing the site. Abatement notices, redevelopment approvals, unsafe structure orders, and fire damage all reach public records first. This system reads those records daily and asks the person awarding the work for a site walk, booking 6 to 15 a month.

Where do you find demolition jobs?

Five public sources carry the timing. State and local asbestos notification logs show whole buildings being cleared. Planning portals show approved redevelopments on occupied land. Code enforcement lists unsafe structure orders. Fire incident records flag damaged commercial buildings. City and land bank portals post demolition bids, which the system lists for the estimator without sending email.

Are demolition leads worth buying?

Most demolition leads for sale are homeowner requests to remove a shed or a pool, shared with several contractors. Project data services cover larger work, and every subscriber sees the same job. The records that show a commercial building coming down are public and free, so this system spends its budget on reaching the person who awards the job.

Does cold email work for demolition contractors?

Yes, when the first line names the building and the record behind it, and the offer is a site walk and a budget number. A general capability email to a list of contractors replies below 1%. An email naming the abatement notice or the approved redevelopment replies at 3 to 6%, an estimate for a warmed sending domain.

How much does it cost to market a demolition company?

About $179 a month in tools on n8n Cloud, against $300 to $1,500 a month for project data and $6,000 to $10,000 a month for an estimator doing business development full time. One commercial demolition job typically bills $40,000 to $250,000, so a single award covers years of the tool line.

What is Lead Gen Library?

A directory of industry-specific lead generation systems by 2V Automation. Each system is a documented n8n workflow set you can get as a free spec, a $297 template, or a $2,997 installation.

Who builds these systems?

2V Automation, an n8n Certified Expert Partner. Every spec is designed and QA-imported on a live n8n instance before publishing.

What do I need to run a system?

An n8n Cloud account (about $24/month, and as an n8n partner we recommend it for zero server upkeep; self-hosting on a $10 VPS also works), the tool accounts listed in each spec's stack table, and a separate sending domain for cold email.

Related systems in construction and design

Guides for Demolition Contractors
